WBS in Project Management: A Founder-Friendly Guide + Free Excel Template

Written by Chriss. Independent: no company pays to be recommended here. How we work

Most project plans fail before the first task is assigned. Not because the team is lazy or the idea is bad, but because nobody agreed on what “done” actually means. A Work Breakdown Structure (WBS) fixes that. It is the simplest tool in project management and the one most founders skip — which is why projects drift, budgets slip, and three-week sprints turn into three-month marathons.

This guide explains what a WBS is, how to build one that actually works, and where founders typically break it. It includes a free Excel template with a complete SaaS product launch example decomposed from project goal down to individual tasks, plus a blank template you can use for your own work.

What is a WBS in project management?

A Work Breakdown Structure is a hierarchical decomposition of everything a project must deliver. Think of it as an organizational chart for scope: the project sits at the top, major phases sit below it, work packages sit below phases, and tasks sit below work packages. Every level breaks the level above into smaller, more manageable pieces.

The WBS is not a schedule. It does not tell you when things happen. It tells you what must happen, in what logical groupings, until the sum of the parts equals 100% of the project. That last part matters: the WBS is governed by the 100% rule, which states that the children of any parent task must represent the complete scope of that parent — no overlap, no gaps.

For example, if your project is “Launch a SaaS product to 100 paying customers,” your Level 2 phases might be Discovery, Design, Build, Go-to-Market, Launch, and Operations. Together, those six phases must cover every piece of work required to hit the goal. If you forget customer support setup, your WBS is incomplete and your project will surface that gap at the worst possible moment.

Why founders need a WBS (even for small projects)

Founders run projects without project managers. That is the reality. A WBS compensates for the lack of a dedicated PM in three ways:

  1. It forces scope clarity before work starts. Most scope creep begins with vague definitions. A WBS makes vagueness impossible because every parent must fully decompose into children.
  2. It surfaces missing work early. When you decompose “Build MVP” into auth, billing, core features, hosting, and admin panel, you quickly notice if billing is missing. Without a WBS, that discovery happens two weeks before launch.
  3. It makes estimation possible. You cannot estimate “Build MVP.” You can estimate “Stripe checkout integration (5 days)” and “OAuth setup (3 days).” The WBS is the prerequisite for any realistic timeline.

If your project involves more than one person and more than two weeks of work, a WBS pays for itself in the first review. If you are still deciding what project management approach fits your business, our types of project management guide maps methodologies to team size and risk profile.

The 5-step method to build a WBS

Step 1: Write the project scope in one sentence

If you cannot describe the project in one sentence, you are not ready to build a WBS. The sentence should name the deliverable and the success criterion. Example: Launch a SaaS product to 100 paying customers within 120 days. This sentence becomes your Level 1.

Step 2: Identify 4-6 major phases (Level 2)

Break the project into major phases that each produce a measurable outcome. A good phase is something you could present to an investor and they would understand what was accomplished. Common phases for a founder-led project:

PhaseTypical deliverableDuration
Discovery & ValidationConfirmed problem-solution fit, waitlist2-3 weeks
Design & PrototypingClickable prototype, user story map2 weeks
Build MVPWorking product in staging environment4-6 weeks
Go-to-MarketLanding page, pricing, onboarding flow2-3 weeks
Launch & IteratePublic release, first 100 users2 weeks
Post-Launch OperationsAnalytics, support playbook, roadmap v22-3 weeks

Apply the 100% rule: these phases, taken together, must equal the full project scope. No phase should overlap with another.

Step 3: Decompose phases into work packages (Level 3)

A work package is a deliverable or outcome that one person can own and that you can estimate in days. It is not an activity. “Code Stripe API” is an activity. “Billing integration” is a work package that includes the API, the webhook handling, the invoice logic, and the error states.

Rule of thumb: each work package should take 5-15 days. If it takes less, it may be a task (Level 4). If it takes more, break it further.

Step 4: Break critical work packages into tasks (Level 4)

Not every work package needs Level 4 detail. Decompose only the packages that are complex, risky, or unfamiliar to the team. A Level 4 task should take 1-3 days. If a task takes more than two weeks, it is probably hiding sub-tasks.

Example decomposition for “Core feature build” (Level 3):

  • Database schema (3 days)
  • API endpoints (4 days)
  • Frontend screens (4 days)
  • Integration tests (3 days)

Step 5: Validate the 100% rule at every level

For every parent node, ask: Does the sum of my children equal 100% of the parent, with nothing extra and nothing missing? Fix gaps and overlaps before anyone starts work. This validation takes 15 minutes and saves weeks of rework.

Real example: SaaS product launch WBS

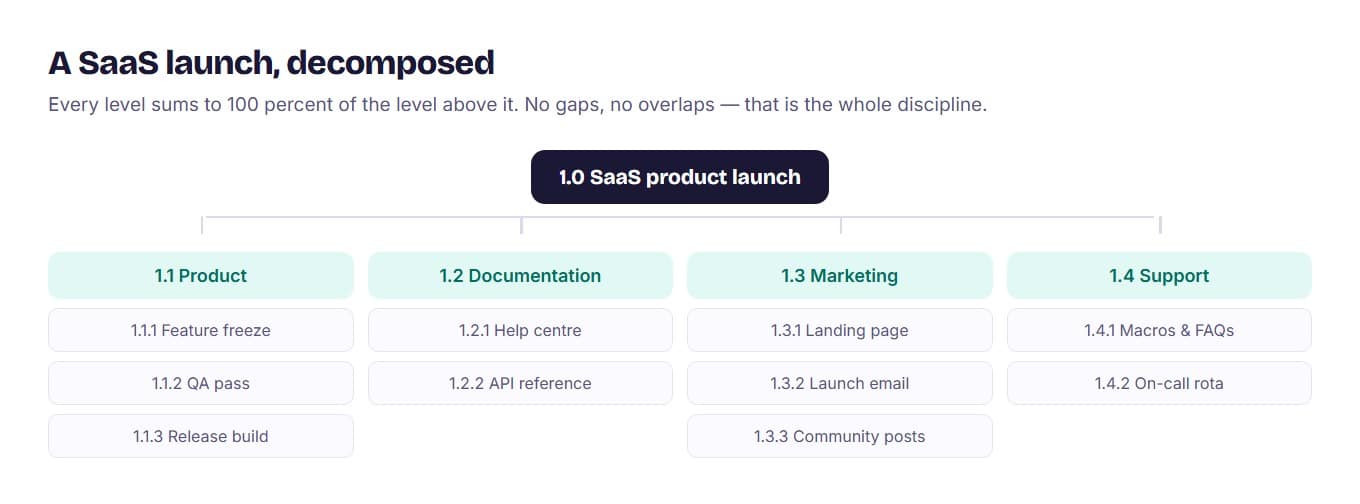

A work breakdown structure tree for a SaaS launch, decomposed into product, documentation, marketing and support branches with work packages beneath each.
Three levels of a SaaS launch breakdown. The lowest level is the work package — small enough to own, estimate and finish.

The template includes a complete example for a founder launching a SaaS product. Here is the structure at a glance:

LevelCodeItemOwnerStatus
11SaaS Product LaunchFounder / CEOIn Progress
21.1Discovery & ValidationFounderDone
21.2Design & PrototypingFounder + DesignerDone
21.3Build MVPFounder + DevIn Progress
21.4Go-to-MarketFounder + GrowthNot Started
21.5Launch & IterateWhole TeamNot Started
21.6Post-Launch OperationsFounder + PMNot Started
31.3.1Tech stack setupDevDone
31.3.2Auth & user managementDevDone
31.3.3Core feature buildDevIn Progress
31.3.4Billing integrationDevNot Started
31.3.5Hosting & deploymentDevDone
31.3.6Internal admin panelDevNot Started
41.3.3.1Database schemaDevDone
41.3.3.2API endpointsDevIn Progress
41.3.3.3Frontend screensDevNot Started
41.3.3.4Integration testsDevNot Started

The full example in the template includes descriptions, durations, owners, and dependencies for every item across all four levels. Use it as a reference for structure, then replace the content with your own project.

The 6 mistakes that break a WBS

  1. Making it a todo list. A WBS decomposes deliverables, not actions. “Write email copy” is an action. “Onboarding flow” is a deliverable that includes copy, design, logic, and testing. Keep outcomes, not tasks, at Level 3.
  1. Mixing phases and tasks at the same level. If one Level 2 item is “Build MVP” and another is “Write landing page headline,” your hierarchy is broken. Levels must be consistent. Broad outcomes at Level 2, specific packages at Level 3, granular tasks at Level 4.
  1. Stopping at Level 2. A WBS with only phases is a table of contents, not a plan. Most projects need at least Level 3 to be useful for estimation and assignment. The template goes to Level 4 where complexity demands it.
  1. Forgetting dependencies. A WBS without dependencies is just a list. The template includes a Dependencies column so you can see that “API endpoints” waits on “Database schema” and “Core feature build” waits on the prototype. Dependencies turn a WBS into a planning tool.
  1. Assigning multiple owners to one work package. One owner per package. If three people own it, nobody owns it. Use a RACI matrix alongside your WBS to clarify who is responsible, accountable, consulted, and informed without breaking the single-owner rule.
  1. Never updating it. A WBS is a living document. When scope changes — and it will — update the structure and re-validate the 100% rule. A stale WBS is worse than no WBS because it creates false confidence.

WBS vs. other project tools

A WBS does not replace other project management tools. It works with them:

ToolWhat it answersWhen to use it
WBSWhat work is in scope?At project start, before scheduling
Gantt chartWhen does each task happen?After WBS is complete, to build timeline
RACI matrixWho owns what?After WBS, to assign roles per work package
Meeting agendaHow do we stay aligned?Weekly, using WBS progress as the agenda backbone

If your team already runs weekly reviews with a structured agenda, the WBS becomes the source of truth for what to report on. Each work package owner updates status, and the agenda writes itself.

Free WBS Excel template: what’s inside

Download the free WBS Excel Template — three sheets designed for immediate use:

  • Example — SaaS Launch: A complete 4-level WBS for a SaaS product launch, with real tasks, durations, owners, dependencies, and status tracking. Study the structure, then adapt it.
  • Template (Blank): A pre-formatted WBS with starter rows, color-coded levels, status dropdowns, and frozen header rows. Replace the placeholders with your project and start decomposing.
  • How to Build a WBS: A built-in guide covering the 5-step method, the 100% rule, common mistakes, and how WBS fits with Gantt and RACI. Share it with team members who have never built one before.

The template uses the same color logic as the example: dark headers for the project, violet for phases, light violet for work packages, and near-white for tasks. Status is controlled by dropdown (Not Started, In Progress, Done, Blocked, Deferred). Dependencies are listed as WBS codes so you can trace the critical path visually.

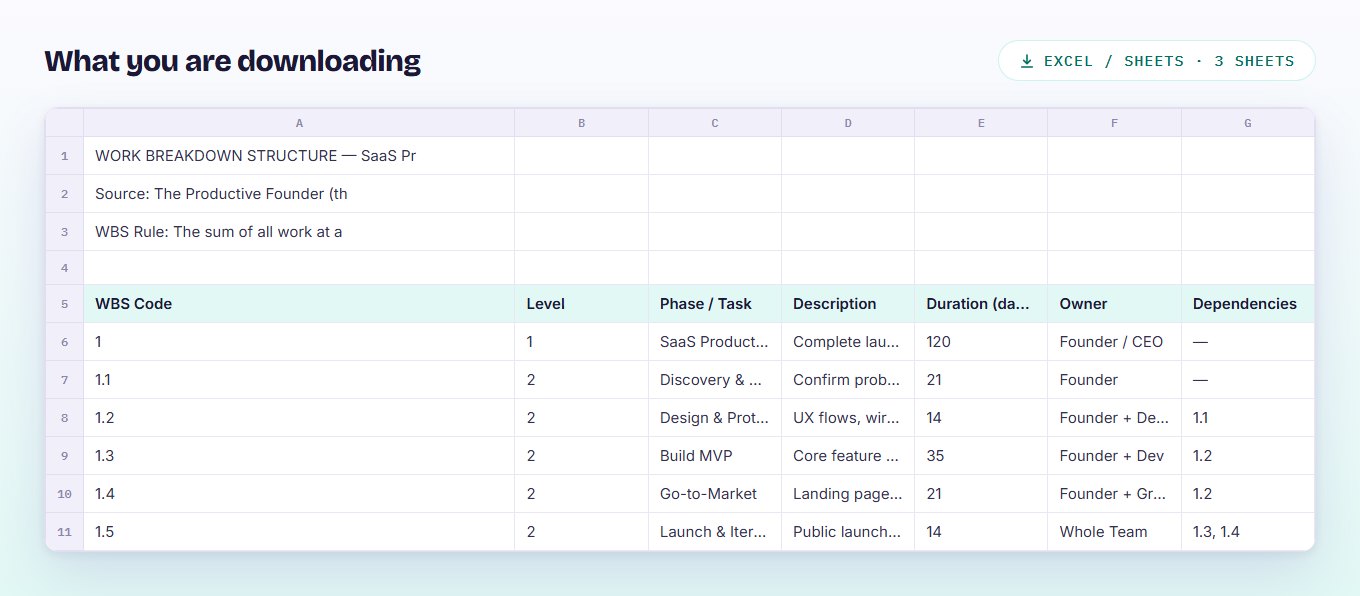

Preview of the work breakdown structure spreadsheet, showing WBS codes, levels, phases, durations, owners and dependencies for a SaaS launch.
The worked SaaS launch: WBS codes, levels, durations, owners and dependencies. A blank template and a how-to sheet sit beside it.

Frequently asked questions

What does WBS stand for in project management?

WBS stands for Work Breakdown Structure. It is a hierarchical decomposition of a project’s total scope into smaller, more manageable components, governed by the 100% rule that requires every parent task to be fully represented by its children with no overlap or gaps.

What is the 100% rule in WBS?

The 100% rule states that the sum of the work at any child level must equal 100% of the work represented by the parent level. No work should be omitted, and no work should be counted twice. This rule is what makes a WBS structurally sound and useful for scope control.

How many levels should a WBS have?

Most projects need at least three levels: project, phases, and work packages. Complex or risky projects benefit from a fourth level of tasks. More than four levels is usually over-engineering for a small team. The template supports four levels with visual hierarchy.

What is the difference between a WBS and a Gantt chart?

A WBS defines what work must be done and how it decomposes hierarchically. A Gantt chart defines when that work happens, who does it, and how tasks sequence over time. Build the WBS first, then convert it into a Gantt chart for scheduling.

Can I use a WBS for a one-person project?

Yes. Solo founders benefit from WBS discipline because it prevents the “I will figure it out as I go” trap that turns two-week projects into two-month projects. The decomposition forces you to think through dependencies before you are deep in build mode.

Is a WBS used in Agile?

Yes, but differently. In Agile, WBS is typically applied at a higher level (epics and features) rather than sprint-level tasks. The 100% rule still applies at the epic level. Daily sprint tasks live in the backlog, not the WBS. For more on methodology fit, see our types of project management guide.

A project plan needs a scope foundation. Our project plan guide turns WBS work packages into a timeline with owners, budget, and risks — including a free Excel template with a SaaS launch example.

The bottom line

A WBS is scope insurance. It costs one focused hour to build and saves multiples of that in prevented drift, missed dependencies, and scope arguments. The 100% rule is the only theory you need: every parent fully decomposes into children, no overlap, no gaps.

Download the template, pick your project, write the scope sentence, break it into 4-6 phases, decompose into work packages, and validate. That is the entire method. For the scheduling layer, use the WBS as input to your project management tool — whether that is a dedicated platform like monday.com or a simple spreadsheet. If you are still choosing the right tool, our project management guide for small business covers the full stack from WBS to go-live.
